Copilot Studio Best Practices for Projects That Reach Production

The success of any Copilot Studio project hinges on proper scoping – not just coding. Without addressing key areas like data readiness, governance, and integration dependencies upfront, projects risk costly delays and failure in production. This guide outlines how to scope effectively, ensuring your AI agent meets business goals, integrates seamlessly, and avoids surprises.

Key Takeaways:

  • Scoping is 80% of the work: Most challenges arise from unaddressed gaps in the client’s environment, not during development.
  • Define clear objectives and KPIs: Align AI capabilities with specific business goals (e.g., reduce support tickets, improve CSAT).
  • Ask the right discovery questions: Understand the client’s systems, constraints, and readiness for AI integration.
  • Assess data and integration readiness: Ensure systems are accessible, data is structured for AI, and connectors aren’t blocked by policies.
  • Set boundaries in the SOW: Clearly define in-scope vs. out-of-scope items to prevent scope creep and disputes.

Why This Matters:

Skipping these steps often leads to blocked connectors, unstructured data issues, or unclear ownership – problems that derail projects late in the process. With the right scoping framework, you can avoid these pitfalls and deliver AI solutions that truly work in production.

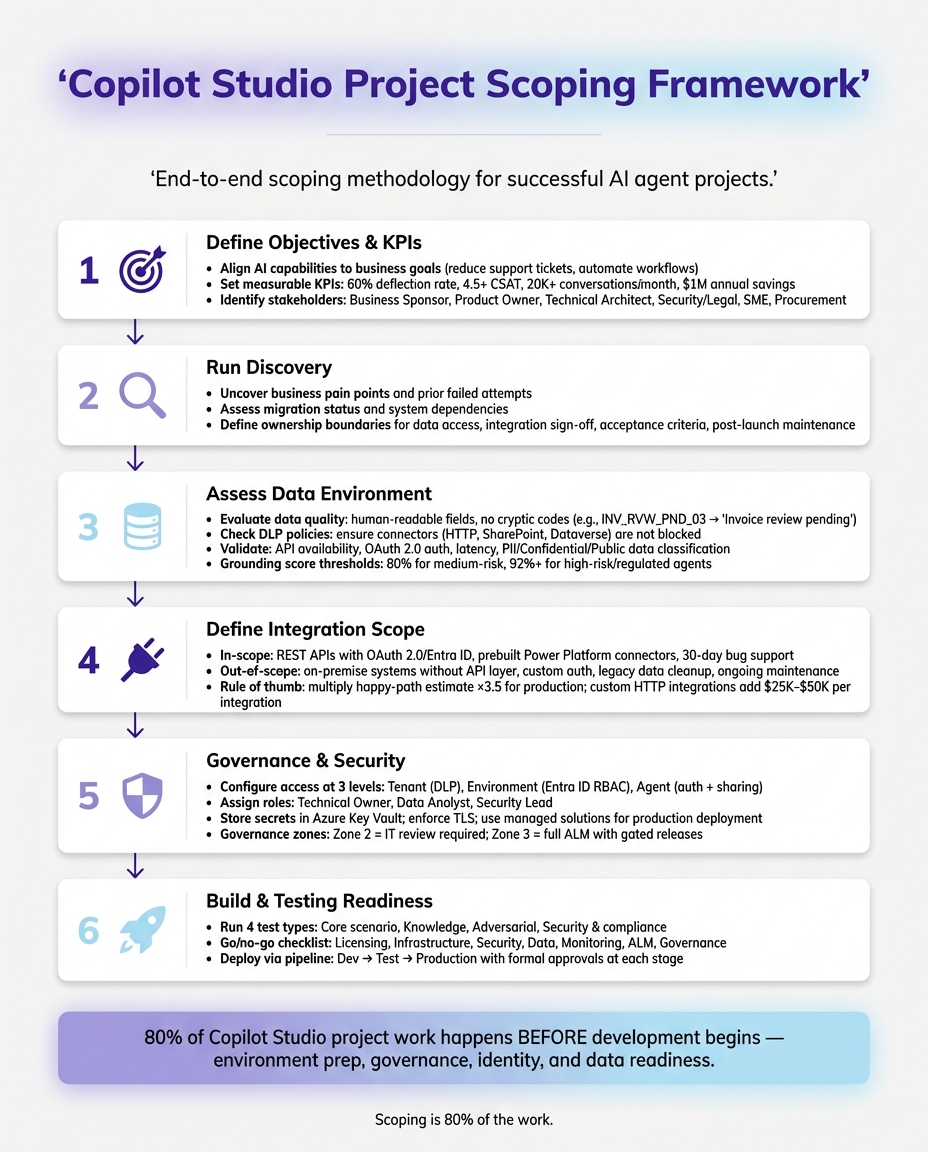

Copilot Studio Project Scoping Framework: From Discovery to Production

Copilot Studio Project Scoping Framework: From Discovery to Production

Lessons: Deploying Copilot Studio in enterprise software environments | BRK157

Copilot Studio

Defining Project Objectives and Production Criteria

Before diving into any topic in Copilot Studio, it’s crucial to establish a shared understanding of success. Without this clarity, partners and clients might measure outcomes differently, leading to disagreements about whether the project achieved its goals.

Aligning Business Goals with AI Agent Capabilities

The process begins with identifying the exact business problem the AI agent will address. Is the goal to reduce inbound support requests? Speed up HR inquiries? Automate invoice status checks? The answer to these questions determines the technical path forward.

The next step is matching the business problem to the right integration pattern. For instance:

  • A read-only HR policy agent might rely on Knowledge Sources.
  • A CRM update workflow may require Power Platform Connectors.
  • A more custom solution might need Custom HTTP.

Starting with the wrong alignment can lead to expensive rework later. To avoid this, use targeted user stories to define the project’s scope. For example, a story like "As a frontline employee, I want to check my leave balance without calling HR" is specific, measurable, and tied to a clear business goal. This approach also helps prioritize a Minimal Viable Agent (MVA) – one that addresses the most critical use cases first and evolves based on real-world feedback.

Identifying Key Stakeholders and User Groups

Once objectives are set, the next priority is identifying and involving key stakeholders. Bringing the right people into the conversation early – and clearly defining their roles – can prevent delays or roadblocks later in the project.

"Defining the scope of the agent’s role… helps set realistic expectations and guides design decisions." – Microsoft Learn

Here’s a breakdown of core stakeholder roles and their responsibilities during the scoping phase:

Stakeholder RolePrimary Responsibility in Scoping
Business SponsorEstablishes business value, funding, and overall vision
Product OwnerLinks objectives to measurable outcomes and KPIs
Technical ArchitectEnsures environment readiness and validates integrations
Security/Legal TeamReviews data ingestion policies and clarifies risks
Subject Matter ExpertProvides domain expertise for intent recognition
ProcurementHandles licensing and SKU confirmations

It’s especially important to involve IT and security teams early. Overlooking them can lead to issues like blocked connectors if Data Loss Prevention (DLP) policies haven’t been reviewed before development begins. Addressing these roles upfront minimizes surprises later in the project.

Setting Measurable KPIs for Success

Ambiguous goals like "improve efficiency" often lead to confusion when it’s time to evaluate the project. Instead, set clear, measurable targets from the start to ensure everyone agrees on what success looks like.

Some common benchmarks for production-ready AI agents include:

TeamCentral

Curious how this applies to your organization?

Talk with the TeamCentral team about practical examples, common questions, and opportunities specific to your business.

Email Us
  • Deflection rate: Aim for 60%, up from a baseline of around 20%.
  • Customer Satisfaction (CSAT): Target a score of 4.5 or higher.
  • Conversation volume: Handle over 20,000 interactions per month.
  • Cost savings: Successful implementations often save around $1 million annually.

The required accuracy threshold should also reflect the agent’s risk profile. For example, an internal HR bot might need 85% factual accuracy, while a financial services agent operating in a regulated industry should meet or exceed 92% accuracy before deployment. Setting clear go/no-go thresholds in writing before development begins ensures objective decision-making at launch.

With well-defined objectives and KPIs, you lay the groundwork for effective discovery and scoping.

Discovery Questions to Ask Before Writing the Statement of Work

Discovery is your opportunity to uncover potential scope gaps before they turn into expensive change orders. By asking the right questions early in the process, you can avoid missteps and ensure the Statement of Work (SOW) is solid. Many scope gaps don’t arise during development – they were there from the start but went unnoticed. A thorough discovery phase helps you surface these gaps and set the project up for success.

Understanding the Client’s Business Goals and Pain Points

Before you even think about drafting the SOW, make sure the project addresses a clear and specific problem. Ask the client to pinpoint the exact issue they’re facing: Where are inefficiencies happening? What’s overwhelming their help desk? Which manual processes are slowing things down?

Their answers will help you identify the right integration approach. For example:

  • If employees struggle to find HR policy documents, they might need a knowledge source agent.
  • If call notes are being logged manually into a CRM, a connector-based workflow could streamline the process.

It’s also critical to ask if they’ve tried solving this problem before and why those attempts fell short. This often uncovers hidden constraints or challenges that won’t show up in technical diagrams but could derail the project later.

Once you understand the business needs, shift focus to the technical readiness of their systems.

Assessing Migration Status and System Dependencies

This step ensures the technical environment is ready for the planned integration. It’s a mistake to assume that just because a system exists, it’s integration-ready. That assumption can lead to costly surprises.

Key questions to ask include:

  • Are any of the target systems currently undergoing migration?
  • Is the SharePoint environment fully indexed?
  • Do on-premise databases have an API layer?

For example, legacy SQL databases accessed via ODBC cannot be integrated natively with Copilot Studio without first creating an API bridge, such as a .NET shim or an Azure SQL connector. This is a separate project that must be scoped and priced before signing the SOW.

Another critical area is data shape. Large Language Models (LLMs) struggle with backend codes that lack clarity. For instance, an SAP field returning INV_RVW_PND_03 won’t mean anything to an AI agent unless there’s a layer translating it to something like “Invoice review pending”. Addressing data legibility during discovery can save you from expensive rework during User Acceptance Testing (UAT).

Defining Ownership Boundaries and Responsibilities

A lack of clear ownership is one of the biggest reasons Copilot Studio projects encounter issues after launch. Defining responsibilities upfront ensures smoother execution and fewer surprises down the road. Before finalizing the SOW, assign ownership for every integration point, data source, and post-launch task.

Here’s a quick guide to the key ownership questions to ask:

AreaQuestion to Ask the Client
Data AccessWho approves AI ingestion for each data source?
Integration Sign-offWho owns the API or connector on the client’s IT side?
Acceptance CriteriaWho decides whether the agent’s output meets expectations?
Post-Launch MaintenanceWho will handle knowledge source updates and performance monitoring?
Security ReviewHas someone been assigned to approve authentication patterns?

One critical question to always include is: “Who decides whether the output is good enough?”. Without a clearly identified approver and well-defined acceptance criteria, disagreements about AI output quality can arise – and they tend to surface at the worst possible moment, right before go-live.

Assessing the Client’s Data Environment

Once discovery answers and ownership boundaries are finalized, the next step is a detailed technical assessment of the client’s data environment. Skipping this phase can lead to wasted time and resources later. A Copilot Studio agent is only as effective as the data it can access and interpret. If the data is disorganized, overly restricted, or incompatible with large language model (LLM) processing, even the best prompt engineering won’t resolve those issues. These technical checks create the groundwork for a smooth integration process.

Evaluating Source Systems and Data Quality

Data quality issues are a frequent cause of delays during production. Addressing these early helps avoid expensive rework during User Acceptance Testing (UAT). The first priority is ensuring the data is structured in a way that supports LLM processing.

Cryptic field values are a common problem. As Michael Ridland, Founder of Team 400, explains:

"JSON that’s three levels deep with cryptic field names will confuse the agent and produce hallucinated outputs."

For example, codes like INV_RVW_PND_03 should be translated into clear, human-readable terms such as "Invoice review pending." If source systems like SAP, legacy SQL databases, or custom line-of-business (LOB) applications provide data in this format, a translation layer should be included in the project scope and budget.

Additionally, confirm that the data is both accurate and up-to-date. For medium-risk agents, knowledge grounding evaluation scores should reach at least 80% before deployment. In high-risk or regulated scenarios, this threshold rises to 92% or more for critical business accuracy. If grounding quality cannot be verified during this phase, it should be flagged as a potential issue in the Statement of Work (SOW).

Checking Governance Constraints and Security Policies

Data governance policies often become roadblocks for Copilot Studio deployments. A common issue is conflicts with Data Loss Prevention (DLP) policies. For instance, if a required connector like HTTP, SharePoint, or Dataverse is marked as "Blocked" in the Power Platform admin center, the agent cannot be published. The Publish button will be disabled, and resolving the issue may require IT intervention, which can take days or even weeks.

To avoid this, identify all connectors the agent will use and confirm that none are blocked or part of conflicting DLP groups before development begins. Securing policy exceptions after the build phase is both time-consuming and avoidable.

Data classification is another critical factor. Work with the client to determine whether the data the agent will access is classified as PII (Personally Identifiable Information), Confidential, or Public. These classifications dictate the security measures required before ingestion and may influence whether the agent can operate in specific environments. As noted in Microsoft’s Copilot Studio documentation:

"Organizational data is the most important asset that administrators are responsible for safeguarding. The ability to use that data in a protected way… is a cornerstone of data security."

Once governance and security concerns are addressed, confirm the systems’ compatibility with Copilot Studio.

Assessing Integration Readiness and Access Patterns

The final step is ensuring system connectivity, authentication, and performance meet the necessary standards. Verify that documented APIs or prebuilt connectors are available, confirm the appropriate authentication method (delegated or service principal), and check that response times align with production requirements.

Choosing between delegated permissions (On-Behalf-Of) and service principal permissions (application-level) is key to balancing security and user experience. Delegated permissions offer enhanced security but introduce complexity in consent workflows. In contrast, application permissions are simpler to implement but require additional backend safeguards to prevent unauthorized data access.

For agents that are customer-facing or voice-enabled, latency isn’t just a user experience issue – it can block deployment. During the assessment phase, document expected response times and flag any endpoints that fail to meet acceptable thresholds. A thorough evaluation here ensures clear integration requirements can be defined in the SOW.

Check CategoryWhat to Validate
API AvailabilityREST API or prebuilt connector exists; no custom shim required
AuthenticationOAuth 2.0, API key, or Entra ID; delegated vs. application permissions
Connector DLP StatusRequired connectors are not blocked in the Power Platform admin center
Data ShapeField values are human-readable; no cryptic codes or deeply nested JSON
LatencyBackend response times are suitable for production
Data ClassificationPII, Confidential, or Public status confirmed for all ingested data

Defining Integration Scope Boundaries

A thorough assessment of the client’s data environment is just the first step. Clearly defining the scope of integration is essential to avoid unexpected challenges. Without written boundaries, scope creep – responsible for 52% of software projects exceeding their budgets – can quickly derail a project.

In-Scope vs. Out-of-Scope Integrations

The most effective way to avoid disputes is to create a clear, two-column list that outlines what’s included and what’s excluded. A useful rule of thumb: systems with a functional REST API and standard authentication methods like OAuth 2.0 or Microsoft Entra ID typically qualify as in-scope. Conversely, systems requiring custom authentication, deeply nested JSON with unclear fields, or only ODBC connectivity should be placed in the out-of-scope column – unless a separate middleware or API shim project is explicitly planned and budgeted. On-premise integrations often fall into the out-of-scope category due to their added complexity.

Integration ComponentIn-ScopeOut-of-Scope
Data FlowRead/write access to specified cloud SaaS systemsData cleanup, de-duplication, or legacy data enrichment
APIsNamed REST APIs with documented endpointsCustom API development for systems without existing APIs
ConnectorsPrebuilt Power Platform connectors (e.g., Salesforce, ServiceNow)On-premise systems without a gateway or API layer
Auth PatternsOAuth 2.0, Entra ID, API keyUnsupported custom authentication
Post-Launch30-day bug support for in-scope integrationsOngoing maintenance, new connectors, or end-user training

Assigning Ownership and Approval Responsibilities

Every integration point requires a clearly designated owner on both the client and partner sides. As highlighted during the discovery phase, defined ownership ensures accountability. Assign a Technical Owner to validate integrations and a client SPOC (Single Point of Contact) to approve deliverables. For larger enterprise deployments, consider forming an Executive Steering Committee with 3 to 7 stakeholders, including decision-makers like the CIO or COO, to oversee major decisions or changes to the solution blueprint. These roles should be documented before development begins to avoid confusion later.

Writing Explicit Scope Limitations into the SOW

Ambiguity in a Statement of Work (SOW) can lead to costly misunderstandings. Phrases like "support", "assist with", or "as needed" leave too much room for interpretation, often skewing expectations in the client’s favor at the expense of the partner’s budget.

"Scope creep doesn’t start when the client asks for ‘one more thing.’ It starts when the SOW leaves room for interpretation." – Jenna Green, Marketing Lead, Magnetic

Replace vague terms with precise, measurable commitments. For instance, specify "up to 10 hours per month of post-launch support" or "email response within 1 business day." Include a Change Order clause that requires written approval for any additional work, along with a clear outline of how it will affect costs and timelines. Additionally, add a client responsibility clause to address delays. For example, if the client fails to provide API access or test data within a set timeframe (e.g., 5 business days), the project timeline should be adjusted accordingly. These well-defined boundaries help ensure smoother execution and lay the groundwork for rigorous testing.

Governance, Security, and Post-Launch Ownership

Establishing clear integration boundaries is just the start – strong governance practices are essential to maintain stability in production. Once integration boundaries are finalized in the Statement of Work (SOW), governance plans should outline key responsibilities: who controls access, who manages the system after launch, and how updates will be handled.

Role-Based Access and Data Security Requirements

Access controls must be configured at three levels – tenant, environment, and agent – before any data flows are activated. Proper setup at each level ensures security and operational readiness.

  • Tenant Level: Administrators enforce global Data Loss Prevention (DLP) policies to block unauthorized connectors and data sources.
  • Environment Level: Access is scoped using Microsoft Entra ID security groups, with defined Role-Based Access Control (RBAC) roles.
  • Agent Level: Authentication methods, sharing permissions, and web channel security settings are configured to ensure safe operations.

"Assign access through Microsoft Entra ID groups, not individuals: Centralize identity and environment access management by using groups to simplify audits and reduce risk." – Microsoft Learn

For Copilot Studio deployments, three Dataverse roles are most relevant: Environment Maker (authoring permissions), System Administrator (full CRUD access), and Bot Transcript Viewer (read-only access to conversations). Assign roles based on actual needs to avoid over-permissioning. For critical agents, strengthen security by implementing network-level controls like VNETs, IP firewalls, and service-to-service call validation to minimize data exfiltration risks. Additionally, store sensitive information, such as API keys, in Azure Key Vault rather than hardcoding them into flows or configurations.

Defining Post-Launch Ownership and Maintenance Plans

To ensure smooth operations post-launch, designate specific individuals for key roles. Assign a Technical Owner to oversee scalability and security, a Data Analyst to track performance metrics such as deflection rates and customer satisfaction (CSAT), and a Security Lead to manage compliance with DLP policies and conduct regular audits. These roles are essential, particularly for agents handling production data in large enterprises.

Runtime updates are deployed instantly, while manifest updates require versioning and administrative redeployment. Your maintenance plan should address both scenarios, ensuring the support team understands the differences. Enable Application Insights for production agents to detect integration failures or latency issues proactively, rather than relying on user reports.

Approval Workflows for Changes and Updates

Changes to production agents, regardless of size, should follow a structured process: Development → Test → Production, with formal approvals at each stage. This approach prevents scope drift after launch.

Agents should be categorized by governance zones to determine the appropriate level of oversight. For example:

  • Zone 2: Departmental agents require IT-admin review before publishing.
  • Zone 3: Enterprise-grade, mission-critical agents demand a full Application Lifecycle Management (ALM) process with gated releases.

Always deploy to production as a managed solution to prevent unauthorized customizations in the live environment. Use automation tools like Azure DevOps, GitHub Actions, or Power Platform Pipelines to streamline transitions between development, testing, and production environments. This reduces manual errors and ensures a reliable audit trail.

Build and Testing Readiness

After completing scoping and environment assessments, ensuring readiness for building and testing is critical for a smooth production deployment. Before diving into topic authoring, the project must clear specific readiness gates. Skipping this stage can lead to significant challenges during user acceptance testing (UAT).

Testing Strategy and Evaluation Criteria

A well-rounded testing strategy goes beyond simply checking if a response is correct. Copilot Studio provides three evaluation methods to assess agent performance: text match (checks for exact or partial phrase matches), similarity (compares meaning even with varied phrasing), and quality (scores responses based on relevance, groundedness, completeness, and abstention). All three methods should be applied across appropriate test types to ensure the agent is ready for production.

"Treat testing as a continuous process throughout an agent’s lifecycle." – Microsoft Learn

Before releasing an agent, four types of tests are essential:

  • Core scenario testing: Focuses on the primary, expected workflows (the "happy path").
  • Knowledge testing: Assesses domain-specific accuracy.
  • Adversarial testing: Examines edge cases, unknown intents, and incorrect inputs – often overlooked but critical to avoid public failures.
  • Security and compliance testing: Validates role-based access control (RBAC), conditional access, and sensitivity label enforcement.

For teams conducting large-scale tests, the Copilot Studio Kit offers automated bulk testing capabilities, covering response matches, topic matches, and multi-turn scenarios.

Additionally, decisions regarding delegated permissions (user-specific access) versus application permissions (service-to-service access) need to be finalized before the build phase begins. Changing these permissions mid-project often requires rebuilding the integration layer, causing significant delays.

By clearly defining testing criteria, teams can ensure that readiness gates are met, guiding the go/no-go decisions that determine whether the agent is truly prepared for production.

Release Readiness Checklist

The release checklist serves as a binary gate – each item must either PASS or FAIL. Security and reliability leave no room for partial credit. Making a go/no-go decision without documented criteria is not a decision; it’s a gamble under time pressure.

CategoryWhat to Verify Before Go-Live
LicensingEnsure active Copilot Studio and Power Platform licenses are in place and link the Azure subscription (if using AI Foundry).
InfrastructureConfirm Dev/Test environments are provisioned, Dataverse is enabled, and DLP exceptions are approved for required connectors.
SecurityVerify Entra ID roles are assigned, TLS is enforced on endpoints, and secrets are stored in Azure Key Vault (not hardcoded).
DataValidate knowledge sources (e.g., SharePoint, APIs) and confirm classification of PII and confidential data.
MonitoringEnable Application Insights, configure error rate alerts, and set up latency dashboards.
ALMEnsure automated deployment pipelines are in place and the rollback plan is documented and tested in pre-production.
GovernanceAssign a technical owner, obtain project sponsor sign-off, and define a change management process.

Manual configuration settings not included in the managed solution – such as Application Insights connections, manual authentication settings, and channel-specific options – must be set up directly in the production environment after deployment. These steps should be included in the deployment runbook to avoid last-minute issues on launch day.

Common Scoping Omissions and What They Cost

Identifying gaps in project scoping is critical, especially after evaluating build and testing readiness. Even small oversights can lead to costly delays. As noted earlier, failing to properly scope data and integration layers can undermine production readiness. These issues often remain hidden until late in the process – during User Acceptance Testing (UAT), just before go-live, or even on the first invoice – causing major setbacks.

Missing Data Access or Integration Readiness

One of the most frequent challenges in Copilot Studio projects is discovering mid-build that the data is either inaccessible, poorly structured, or unsuitable for AI processing. Strict Data Loss Prevention (DLP) policies and the absence of a translation layer for cryptic codes can lead to unexpected hurdles.

"In most engagements, the actual implementation is maybe 20 percent of the work. The other 80 percent shows up before and around the build. It’s time spent understanding the client’s environment, their constraints, and their readiness for AI." – MNP Digital

Large Language Models (LLMs) struggle to interpret complex formats like nested JSON or obscure internal codes such as INV_RVW_PND_03. If no one plans for a translation layer to convert raw system data into readable text, this task often becomes an unplanned, urgent, and costly addition during the project. Beyond data challenges, poorly defined roles can exacerbate risks.

Unclear Ownership and Responsibility Gaps

Undefined ownership of the knowledge base after launch can lead to performance issues and unexpected operational costs. It’s important to recognize that AI features require ongoing maintenance, not just a one-time investment.

"The feature isn’t just a build cost; it’s an ongoing expense. Some clients are surprised by this. Better surprised in the proposal than on the first invoice." – Anurag Verma, Founder & CEO, CoderCops

Lack of clear ownership also slows decision-making during the project. For example, when questions arise about authentication methods, connector licensing, or scope changes, not having a designated decision-maker can create delays that ripple through the timeline.

Underestimating Integration Complexity

Another common issue is misjudging the complexity of integrations, which can significantly drive up costs. The gap between a successful demo and a production-ready integration is often underestimated. Demos work in controlled environments – upload a SharePoint site, ask a question, and get a clean response. But when clients request connecting that same agent to an ERP system or automating ticket updates in ServiceNow, the complexity skyrockets.

"The demo always works. You drag in a SharePoint site, ask the agent a question, and it pulls back a tidy answer… Then someone says ‘great, now connect it to our ERP and let it update tickets in ServiceNow,’ and the room goes quiet." – Michael Ridland, Team 400

Building production-ready integrations involves much more than simple API calls. It requires managing authentication, handling token refreshes, implementing rate limiting, retry logic, error handling, and state reconciliation. A good rule of thumb: multiply a developer’s "happy-path" estimate by 3.5 to account for production-level requirements. For custom HTTP integrations with internal systems, budgets typically increase by $25,000–$50,000 per integration, with authentication alone requiring 2–4 weeks of work. Treating integration as a straightforward task is a recipe for missed timelines.

Scoping Template for Copilot Studio Projects

A well-structured scoping template is essential for avoiding unexpected challenges during a project. It aligns with Copilot Studio’s approach to creating production-ready solutions. Common pitfalls, such as missing data access, unclear ownership, or underestimated integrations, often arise when scoping is overlooked. By addressing these issues upfront, a reusable scoping template ensures that critical gaps are identified before finalizing the Statement of Work (SOW).

Template Structure and Key Sections

The Copilot Studio scoping template is designed to be concise yet comprehensive, ensuring all critical questions are addressed before the SOW is signed.

Template SectionKey Information
Project OverviewProject name, business department, project owner, and a brief description of the primary goal focused on business value.
Business Problem & Use CaseProblem statement, target user groups (e.g., employees, customers, partners), and the outcomes users aim to achieve.
Expected Outcomes & KPIsSuccess metrics such as deflection rate, CSAT score, adoption volume, and cost savings.
User Experience & ChannelsMain channels (e.g., Teams, Web, Mobile, Microsoft 365 Copilot) and conversation style (guided or conversational).
Functional RequirementsCore capabilities, exception handling, human escalation paths, and fallback behavior.
Automation & IntegrationAutomation tools (e.g., Power Automate, RPA) and integration targets (e.g., Dataverse, SaaS apps, custom APIs).
AI & Knowledge SourcesData sources (e.g., SharePoint, OneDrive, websites) and advanced services like Azure AI Search.
Governance, Security & ComplianceData sensitivity levels, authentication methods (e.g., Microsoft Entra ID), RBAC, and regulatory requirements such as GDPR.
ALM & LifecycleEnvironment strategy (Dev/Test/Prod), deployment pipelines, and rollback procedures.
Risks & ConstraintsKey risks (e.g., data quality, external dependencies) and known limitations.
Recommended ArchitectureTechnical pattern selection: native Copilot Studio, hybrid with Azure AI Foundry, or fully custom Azure AI Foundry.

The Expected Outcomes & KPIs section is particularly important. Measurable targets, such as a 60% deflection rate, a 4.5+ CSAT score, 20,000 conversations per month, or $1M in annual support savings, provide a clear, shared understanding of success.

Adapting the Template for Various Projects

Each section of the template can be adjusted to fit the specific needs of a project. While the structure remains consistent, the level of detail varies based on project complexity. For example, a straightforward internal HR or IT helpdesk agent project using native Copilot Studio capabilities will require minimal customization. On the other hand, projects involving advanced retrieval-augmented generation (RAG) or custom model integration will require more detailed input in the AI & Knowledge Sources and Recommended Architecture sections.

The architecture selection process is a key decision point within the template, offering three levels of complexity:

  • Standard: Copilot Studio alone, suitable for use cases fully supported by native capabilities.
  • Advanced: Copilot Studio combined with Azure AI Foundry, ideal for scenarios requiring Azure AI Search or custom models.
  • Custom: Azure AI Foundry only, designed for fully custom agents with deep Azure AI integration.

Other sections, such as Governance, Security & Compliance and Automation & Integration, also need tailoring to reflect the client’s specific requirements. For instance, the governance section should address GDPR compliance, RBAC needs, or regional data residency rules. Similarly, the integration section should clearly outline what is out of scope to avoid disputes during development.

"Treat go-live as the beginning of ongoing improvement rather than the end." – Microsoft Implementation Guidance

This philosophy should guide the ALM & Lifecycle section. From the start, plan for continuous feedback through short sprints, regular demos, and a clear process for post-launch updates. A template that focuses solely on the build phase and ignores the post-go-live lifecycle risks repeating the ownership gaps mentioned earlier.

Conclusion: How Proper Scoping Avoids Problems

Throughout this guide, we’ve explored a detailed approach to scoping, and now it’s clear how thorough planning at the start can prevent costly setbacks later. Many Copilot Studio projects falter not because of coding issues, but because crucial questions were left unanswered. Overlooking ownership responsibilities, failing to vet data sources, or choosing the wrong integration pattern often leads to gaps that only emerge later – costing both time and money to resolve.

Interestingly, the bulk of the work in a Copilot Studio engagement – about 80% – is tied to preparing the environment, addressing identity management, and ensuring governance and security readiness. Skipping these foundational steps doesn’t eliminate the challenges; it merely delays them until after the statement of work is signed and development has begun.

"The AI project that gets scoped properly isn’t always the biggest one. But it’s the one that both sides endorse at launch." – Anurag Verma, Founder & CEO, CODERCOPS

Proper scoping also helps avoid common pitfalls, such as an agent that functions perfectly in development but fails in production due to a data loss prevention (DLP) policy, a knowledge base that deteriorates because no one is responsible for its maintenance, or a tool that, despite being delivered on time, is rejected because stakeholder concerns were ignored.

The methodology and template provided in this guide can be the difference between a project that successfully makes it to production and one that stalls mid-development. Investing an extra week in discovery can save two to three weeks during development. By applying this scoping framework before creating even a single topic, you can sidestep the challenges outlined here. Proper scoping doesn’t just smooth the development process – it ensures that projects achieve meaningful business results once deployed.

FAQs

What is Copilot Studio?

Copilot Studio is a SaaS platform designed to help users create and manage conversational agents. These agents can interact with data, handle tasks, and seamlessly integrate with enterprise systems through generative AI, curated topics, and built-in connectors. The platform covers the entire agent lifecycle, from development to deployment, ensuring smooth management of logic, security, and performance. It also supports multiple channels, including Microsoft Teams, web apps, and SharePoint.

What should be scoped before building an agent?

To achieve success in production, start by clearly outlining the project’s business objectives, data needs, and technical limitations from the outset. Concentrate on a specific use case that involves high data volume or follows established rules. Establish measurable success criteria, ensure data is accessible, and confirm compliance with relevant standards. Evaluate external systems for potential challenges such as API limitations, latency issues, or other risks. Define robust security measures, including role-based access controls and a "kill switch" for emergency scenarios. Finally, calculate operational costs to ensure the project remains financially sustainable as it scales.

What causes Copilot Studio projects to stall in production?

Copilot Studio projects frequently encounter delays in production because of overlooked details in scoping and operational planning during the design phase. Some typical challenges include:

  • Data issues: Problems like low-quality data, isolated datasets, or missing real-time integration can stall progress.
  • Environment conflicts: Security measures and Data Loss Prevention (DLP) policies may block necessary connectors.
  • Operational uncertainties: A lack of clear ownership or maintenance strategies can lead to confusion and inefficiencies.
  • Cost and scalability concerns: Misjudging API expenses or performance limitations can result in unplanned costs and bottlenecks.

Tackling these challenges early on can help sidestep expensive setbacks.

Latest

From the blog

The latest industry news, interviews, technologies,
and resources.
Article

Audit Trails for Copilot Studio Agents: How to Meet Enterprise Security Requirements

Make AI agents audit-ready: enable Purview, export Dataverse transcripts, enforce approvals, and log correlation IDs.
Read More →
Article

Role-Based Access Control for Copilot Studio: What Enterprise Security Teams Need Before Sign-Off

Security checklist to verify RBAC, data-access paths, connector auth, and audit logs before agent production approval.
Read More →
Article

MCP Server Security: Implementing Least-Privilege Access for Copilot Studio Agents

Least-privilege controls are essential to prevent AI agents from becoming a broad attack surface across enterprise systems.
Read More →
